November 2026. Residential approvals, industrial land, new commercial permits and major infrastructure investments are reflected in the project and site inventories. Project status follows the cited records. We have not obtained every historical city and county permit record; Bulloch's November 3 outcomes come from a published meeting summary until the county posts minutes, and scheduled hearings are not decisions.
Purple dots mark park and land context, separately filtered from projects. Project dots are filled when construction has started, solid ring when approved, dashed when only filed. Muted filled dots mark completed or opened projects. Tracts large enough to see are shown as a shaded circle of their stated acreage, centered on the project; it shows size, not the property line. Most original project points remain approximate. Cannady uses its state-hosted listing location; revalyu, the Metter industrial park and Southeast Bulloch High School use matched addresses; the R&H planned development sits on its road, not its parcel. Purple markers identify park or facility context, not property lines. Click a dot or a project for its status and source. The table below assigns every residential project in our pipeline data to its nearest growth area. The map has 21 project entries and 9 separately filtered park, facility or listed-building markers. Eleven site profiles appear below; Bruce Yawn and Perimeter Center are described without unverified pins. Markers do not establish vacant land or construction. Available quantities are dated claims, not additive supply.
November 2026 · research update November 13
Bulloch County had 86,949 people and 36,248 housing units in 2025, up 9.2 percent since 2020. Candler County had 11,275 people.1 The residential pipeline includes planned development on Pretoria Rushing Road for up to 500 lots, several subdivisions of 40 to 80 homes moving through plats, and a workforce subdivision of at least 90 homes approved on Abbey Road in October.234 Housing capacity and timing remain closely tied to sewer expansion, particularly in southeastern Bulloch County.
Proposals and applicant estimates are not approvals, financed projects or construction starts. Research review as of November 13; broader permit and municipal records audit remains incomplete.
Statesboro Burkhalter Road data center — permit processing stayed. Although the August 18 rezoning of 26.49 acres at 6539 Burkhalter Road passed 3-2, City Attorney Cain Smith confirmed November 10 that processing of the separate special-use permit remains stayed while the citizen lawsuit is pending. The city asked the court to dismiss the challenge in its October response. City officials have called the earlier application incomplete. Rezoning is not permission to build or operate the proposed 230,000-SF facility (up to 99 MW requested). Statesboro Herald, November 10 · City ordinance.
Canoochee / Metter airport data center — filed, not approved. DRI 4846 describes roughly 470 acres at 2700 Airport Road, five potential buildings of up to 250,000 SF each (1.25 million SF maximum), two substations, applicant-estimated 500 MW peak demand, and 0.2 million gallons/day of proposed groundwater use. Applicant Canoochee River RV Resort LLC targets phased completion in 2033. Its stated $35 billion buildout value is an unverified applicant projection, not investment committed or financed. No confirmed end user, power-service agreement, zoning approval or construction start. A December 8 county hearing is advertised. County DRI 4846 · Application summary.
A separate Metter city-site data center is only an early-stage lead. WTOC reported September 15 that a different group was considering land west of Highway 129 off East Hiawatha Street; the mayor said no formal city application had been received. Metter began recruiting a community data-center task force. Do not conflate this prospect with the airport application or a 43-acre residential listing on Hiawatha Street. WTOC · City task-force notice.
Economic modeling is separate from the development pipeline. Metter published city, county and school fiscal-analysis summaries on September 22 for Project Back in Black, a 100-MW modeled data center. Whether it corresponds to the Canoochee filing or the city prospect has not been established; it is not a third project. The assumptions must be reviewed before quoting revenue or cost impacts. Metter notices and fiscal summaries.
Important unclosed records. The October 2026 Statesboro building-permit report is posted but has not yet been reconciled permit by permit against the ledger; do not infer construction starts. The advertised November 9 Metter rezoning for a 24.97-acre industrial-park addition and the separate 46.76-acre Fortner Road development need official final-vote verification. November 17 Zetterower and December 8 Candler hearings are upcoming, not approvals. City permit reports · Metter notice.
Recent approvals, active work and significant earlier plans still shaping the development pipeline. Status reflects the cited record.
Abbey Road workforce housing Approved
End of Abbey Road, between Jones Mill Road and East Main Street, Statesboro
On October 6 the council approved a preliminary plat for about 40 acres: at least 90 detached homes priced from $200,000 to $290,000 in the first phase, townhomes later. It also approved a development agreement and an application for up to $2.5 million from the state's workforce housing program, with $250,000 from the city. The approval lapses if the grant is not funded, and a wetlands determination is pending.4 The street location is not shown as a precise parcel point on the map.
R&H planned development, Pretoria Rushing Road Approved
Pretoria Rushing Road at Burkhalter Road, Bulloch County
The land was rezoned for a planned development in 2014. In January county staff proposed sending it back to large-lot zoning. Commissioners declined, 3-2, and kept the zoning for two more years with a deadline. The county report puts it at up to 500 lots on 135 acres. No development plan has been filed; the owner is waiting on city water and sewer.2
Chesed Holdings: 30.8 acres for retail on Highway 67 Approved
Highway 67, Bulloch County (parcel 110 000026 001)
Commissioners approved rezoning about 30.8 acres from agricultural to commercial on November 3, unanimously, with 22 conditions the developer accepted; the planning board had recommended it 5-0. That outcome comes from The Georgia Virtue's meeting summary; the county's minutes are not yet posted. A rezoning is not a store. No tenant or site plan has been published.3856 The exact parcel location is not represented as a verified map point.
More county items
The October 20 planning agenda also carried a 63-lot sketch plan on 89.6 acres off Burkhalter Road from Blue Water Bulloch, the developer of the Herman Rushing townhomes; two light-industrial rezonings for Truck & Industrial, an automotive repair business, on Akins Anderson Road (10.1 acres, across from Ecoplastic) and US 301 South (4.1 acres); and larger-store and liquor-store requests from AM PM Convenience Stores at US 80 and Burkhalter.5 On November 3 commissioners approved both Truck & Industrial rezonings with conditions and the liquor-store conditional use, unanimously, and two sand-pit permits on Dekle Road, 4-0. The repair business is not an auto supplier.38 In March the county approved heavy-industrial zoning for Concrete Enterprises' ready-mix and asphalt plant at 12139 US 301 South.7
Statesboro council, October
Both boards approved a $1.2 million design contract for Burkhalter Road on October 6: widening from Langston Chapel Road to east of Herman Rushing, a roundabout at Cawana, and signal work at Fair Road. Construction is about two years off.48 On October 20 the council heard Express Oil's request to rezone 3.5 acres at Fair Road and Veterans Memorial Parkway, which the Statesboro Brief reported passed 3-0, a four-unit infill project on West Inman Street, and an agreement with S&K Investments about a land exchange that does not name the parcels.910 Minutes are not yet posted. The September 15 minutes confirm the WoodSpring Suites rezoning on Tormenta Way passed unanimously. Its developer told the Brief it plans 122 rooms at about $15 million, with site work in December.1112
On November 3 the council cut about $1 million from this year's budget, 4-0, after declining to raise the tax rate. The packet lists $928,758 in cuts; staff had proposed $1.04 million. No layoffs were reported.39
New supply: Pointe Grand
Pointe Grand, 216 apartments on 18.5 acres at 980 Lovett Road, is leasing. Construction began in October 2024. We have not found a completion or occupancy date, so we count it as delivered supply, not a dated completion.40
Public and institutional
East Georgia Regional Medical Center plans a $16 million emergency department expansion, 12 more rooms, finishing late 2027.13 The state set aside $29.8 million for Georgia Southern's new College of Optometry, mostly to renovate a university building on US 301; the Regents approved the degree in October and the first class is planned for fall 2029.1415 Bulloch County won $20 million in July to buy sewer capacity from Bryan County and begin engineering a line along I-16 toward Highway 119, Ash Branch and Highway 67.16 Brooklet received $944,000 to extend sewer downtown.12 The Georgia Southern Foundation's hotel and conference center on Tillman Road is still a plan: the Regents' February agenda describes at least 90 rooms and about 20,000 square feet of conference space on 13.5 acres, sold to the foundation for $2,673,000 and ground-leased to a development company. The Regents can buy it back if no financing or land-disturbance permit is in place within five years. The foundation announced the purchase in May. No developer, brand or start has been announced.41 The hospital project now has a permit and is in the table; the others remain proposed or funded projects, with construction status and exact sites to be confirmed.
Closings and cutbacks
Cardinal Glass filed a state layoff notice for the permanent closure of its plant at 8373 Zell Miller Parkway, the former Viracon plant: 115 workers, with separations starting December 6, 2026 and ending by June 30, 2027.4217 The Sir Shop, a Statesboro Mall clothier since 1971, will close by the end of the year and move its brands to Burlap in Metter; the owner cited the mall's environment.43 Tormenta FC suspended professional play for the 2026 season and the stadium's second phase is on hold; the academy and front office continue, and the club has talked about returning in 2027.44 A closing is not a project. A building may become one later.
What the city's permits show
Statesboro posts a monthly list of building permits. From May through September it issued permits for about 125 new homes: roughly 55 houses, 61 townhomes and 5 duplexes (10 units), spread across a dozen streets in subdivisions already under way.32 The larger permits: $14.15 million for the hospital's emergency department addition on September 9; $11.6 million to renovate Statesboro Summit on September 28; $8 million for a Residence Inn on Woodford Lane in August; $5.9 million for a four-story student housing building, SolA, at 2703 Old Register Road; and about $6.3 million to renovate Laurel Pointe Apartments on East Main. Grange Mill, a Mungo Homes subdivision, pulled permits for its amenity center and pool.3233 A permit is permission to build, not proof of construction. SolA may sit inside the Old Register Road plan; we have not added it to any count.
Updated November 2, 2026. This is an inventory of parks, public development assets and industrial buildings on the market. Public involvement can mean ownership, an authority role or a utility investment; it does not mean every parcel is public or available. These are separate from the construction table and its totals.
Two additions this month are private buildings for sale: about 74,000 square feet on US 301 North near the airport and about 10,000 square feet in Metter. Neither listing is dated, so we date them by our own check. Zoned land is not marketed land. The 360-acre Northpoint tract on Rocky Road, approved for warehouses in 2023, has no construction we can find; the former Aspen Aerogels site at the interchange has no buyer we can find. Neither goes on the map until we can confirm what is there.
| Park / site | Public role | What is there / going in | Available / next check |
|---|---|---|---|
| Gateway Regional Industrial Park Gateway Boulevard / AJ Riggs Road, Bulloch County Established industrial district | Development-authority industrial district; ownership and commitments vary by parcel. | Existing: Authority identifies Walmart at Gateway without specifying Phase I or II. Gateway II tenants are described separately below. Incoming: revalyu's recycling facility is tracked separately; its current operating status remains unconfirmed. | No park-wide vacant-land balance established. Occupied or committed parcels are not available public inventory. Authority park inventory · EPD revalyu address |
| Gateway II / Cannady Site JC Cannady Road off US 301 South, Bulloch County Approximately 70 acres marketed | DABC-led site preparation and recruitment; current parcel title and reservations need confirmation. | Existing: DABC names Great Dane and WL Plastics in the park and revalyu as a planned facility. Incoming: June 2025 grant supports grading and sewer work; completion of the pad-ready work has not been verified. | State-hosted listing updated January 14, 2026 offers 69.70 acres for sale or lease, while its total-acre field says 121.80. Treat these as unreconciled offering/parent figures, not additive supply. Price unit unconfirmed. State-hosted offering · DABC grant announcement |
| Bruce Yawn Commerce Park I-16 / US 301 interchange, Bulloch County Also called Southern Gateway Commerce Park | Authority-sponsored park with committed private industrial projects; no current vacant balance established. | Existing: AJIN Georgia opened in July 2024. Southern Gateway is the former name of this park, not another park. Incoming: Former Aspen project reuse and nearby Northpoint warehouse plans need current parcel reconciliation. | Older marketing acreage is not reliable current availability. Current ownership, commitments and remaining land need checking. Described here without an unverified map pin. State park-name record · AJIN opening, contractor |
| Airport Industrial Park US 301 North / Statesboro–Bulloch County Airport 20–175 acres in a dated offering | Authority-promoted industrial location; current individual titles and airport lease restrictions need checking. | Existing: Industrial location beside the public airport. Incoming: Airport hangar leases, land disposal and utility works are separate leads below; no new industrial tenant confirmed here. | State-hosted listing updated August 12, 2025 advertises 20–175 acres. Confirm present availability and infrastructure before relying on it; this is not a current vacancy certification. State-hosted offering · Authority park inventory |
| Perimeter Center Park US 301 South beside Ogeechee Technical College, Statesboro Office and light-industrial park | Authority-promoted business park; park-wide public fee ownership not established. | Existing: Smaller commercial tenants in an established office-park setting. Incoming: The new Georgia Training Center for Industrial Operations nearby is described separately; it is a public facility, not vacant park land. | No current available-lot or suite inventory established. Park boundary and map anchor remain unconfirmed; retained here for coverage. Authority description |
| Georgia Training Center for Industrial Operations 66 AJ Riggs Road, Statesboro 39,700 SF; approximately $27 million; OPEN | Ogeechee Tech / TCSG public facility. DABC contributed land; county contributed access-road funding. | Existing: Training began October 5 and the grand opening was October 15, 2026. Labs support industrial systems, automation and robotics. Incoming: An operating workforce asset for regional manufacturers, not an active-construction project. | College offers training and employer programs; no vacant development-land offering implied. Facility page gives 39,700 SF; opening release rounds to 40,000. College opening announcement · Facility and address |
| Statesboro City Campus / Business Innovation Group 58 East Main Street and adjoining City Campus buildings, Statesboro Downtown incubator and innovation facilities | City / downtown-authority / Georgia Southern partnership; current building-by-building title and allocation not fully reviewed. | Existing: Business incubation, fabrication and business-assistance programs, with meeting facilities. Incoming: Current expansion or construction phase not established in this pass. | University offers meeting-space rental subject to scheduling. Incubator vacancies and lease terms require confirmation; this is not a vacant land sale. University BIG programs · Space rental |
| Metter–Candler I-16 Industrial Park West Lytell Street / GA 121, Metter 130+ acres advertised; remaining supply unverified | Candler County Industrial Authority markets the park; public or bond-lease title does not make occupied land available. | Existing: DAS opened its seating plant here with an August 13, 2024 ribbon-cutting. Doowon announced a plant in 2024; its operation is unconfirmed. 4 Fungi's Regenerative held a greenhouse groundbreaking in November 2023; current operations and phases need checking. Incoming: Certification/expansion grant, and a proposed 24.97-acre Fortner Road addition (R-4 to light industrial): planning commission October 26, council hearing November 9, 2026. Outcome not yet known. | Undated authority page advertises 130+ acres, not a reconciled vacant balance after tenant commitments. Old conceptual parcel/building plans are not current offers. Ask the authority for remaining lots and terms. Authority inventory · DAS opening, Metter Advertiser · County-posted park tenant agreement · 4 Fungi groundbreaking · Fortner rezoning notice |
| Georgia Grown Innovation Center 25 South Terrell Street, Metter Agribusiness incubator / innovation facility | Created by City of Metter with Georgia Grown and Georgia Southern partners; current deed and operating lease not reviewed. | Existing: Small agribusiness support, consulting, networking and meeting facilities. Incoming: No new construction phase confirmed; tenant businesses' own expansions are separate projects. | Membership and scheduled meeting-space services are offered. Current incubator-space vacancy and terms require confirmation; not an industrial land offering. Center partnership and services · University space and address |
| Industrial building for sale, US 301 North 17264 US Highway 301 N, Statesboro About 74,000 SF on 2.55 acres; built 1989 | Private property; broker listing. No public role. | Existing: Single-tenant industrial building with 10 drive-in doors and 4 docks; zoned HOC. Incoming: No new tenant or project identified. | Listed for sale at $1,000,000. The listing shows no date; we read it November 2, 2026. Confirm with the broker before relying on it. Broker listing |
| Industrial building for sale, Metter 501 Addlestone Drive, Metter About 10,000 SF on 4.28 acres; built 2003, renovated 2026 | Private property; broker listing. No public role. | Existing: Metal warehouse building, zoned M1, about 3 miles from I-16. Incoming: No new tenant or project identified. | Listed for sale at $695,000. The listing shows no date; we read it November 2, 2026. The listing places it in an established industrial park; we have not matched the park name. Broker listing |
Candler County says it received an application for the airport-area proposal but the fees had not been paid; it has posted a concept plan. Reporting in October described the Canoochee River RV Resort group's site near the airport, a planned unit development request and a regional-impact filing.2526 In September the county's industrial authority was reported to be courting a data center near the airport and I-16, possibly through a city annexation. These may be the same project. We do not count them twice, and none has an approval.27 The airport-area filing covers 470 acres at 2700 Airport Road for five buildings and two substations, with a rezoning from agricultural to a planned unit development. The applicant's regional-impact filing estimates 500 megawatts; that is its own estimate. The county has posted notice of a commissioners' hearing on December 8.26
On October 24 Audi picked the Middle Georgia Megasite in Peach County for its first U.S. plant. The state puts it at about $4 billion and 4,500 jobs, with grading in 2027, construction in 2028 and full production in 2031 at up to 200,000 SUVs a year.34 Audi's own release says construction starts in 2027 and production in the early 2030s.35 Audi cited Georgia's existing supplier network as a reason for the choice. It has named no suppliers.
The site sits on Georgia 96 west of I-75, near Fort Valley, about 105 miles west of Metter in a straight line. The county development authority counts 34 miles from the site to I-16 by way of Georgia 96.36 Whether any Audi suppliers land along I-16 is an open question, not a forecast. The plant is outside this market, so the map shows it in an inset instead of zooming out.
Credible leads from public sources. Each needs a location, a count or an official status before it goes in the table.
Statesboro and Metter sit 25 miles apart on I-16. They share a labor pool and the same pull from the east, so we treat them as one market. We cut it into eight areas by what each is mostly adding: two interchanges where the jobs land, a planned new center on Old Register Road, downtown and the campus, two growth edges, a retail corridor, and downtown Metter as a satellite town. Hyundai's Metaplant in Bryan County and OpenAI's planned campus in Effingham County sit outside the market and shape it. Audi's planned plant in Peach County, about 105 miles west of Metter, is a third; see Regional context.
Project stages reflect published decisions, permits, owner announcements and other cited sources as of November 6, 2026. Proposals and feasibility discussions should not be interpreted as construction starts. Submit a project update.
How we count: the table includes filed, approved and started projects in Bulloch and Candler counties. Plan figures count at their approved maximum. Early leads and possible duplicates are not added to totals.
The larger projects, scaled to a market of about 98,000 people: 75 or more homes or apartments, commercial sites of 40,000 square feet or 10 corridor acres, industrial investment of $10 million or 50 jobs, public projects of $10 million or more, and 50 acres annexed or rezoned, plus smaller ones that change a corridor or an interchange. Smaller projects appear in the monthly issues.
The table assigns every residential project in our pipeline data to its nearest growth area. A dash means nothing counted yet, not zero. Counts here are incomplete on purpose. They include projects approved since April 2025 that we could place on the map, plus earlier approvals that still shape their areas: the southeast corridor's planned townhomes and homes, and Brooklet's 300-acre Weyerhaeuser annexation. The southeast count is the city's own figure of about 1,342 units in the Burkhalter and Cawana corridor, including the Herman Rushing Road townhomes. The Hunnicutt subdivision is listed below but not yet placed, and the 714-acre Blue Fern plan is on hold and not counted.

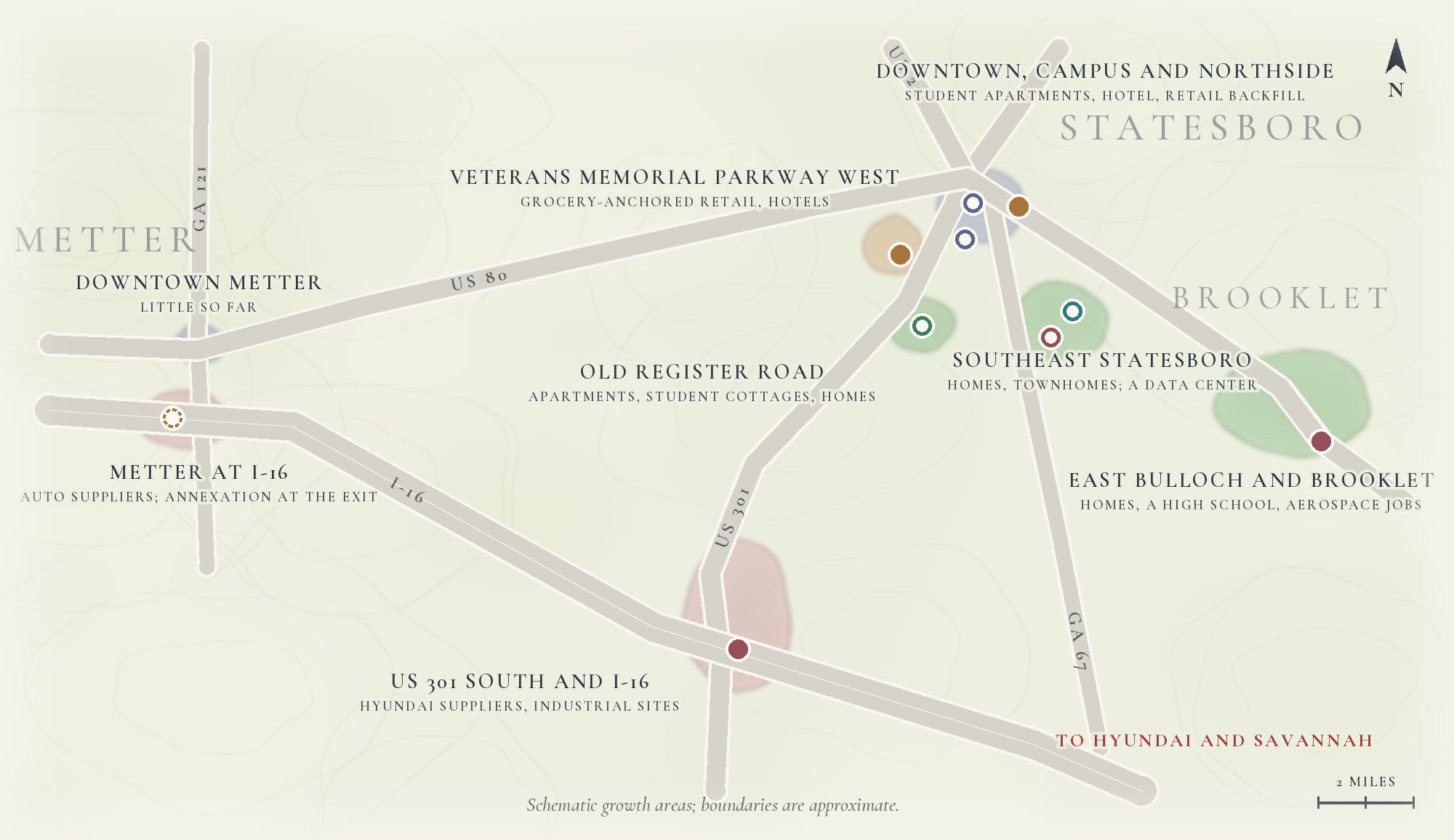

| Growth area | Mostly adding | Homes and townhomes in the pipeline | Apartment units in the pipeline |
|---|---|---|---|
| US 301 South and I-16 | Hyundai suppliers, industrial sites | - | - |
| Old Register Road | Apartments, student cottages, homes | 448 | 725 |
| Downtown, campus and Northside | Student apartments, hotel, retail backfill | 0 | 108 |
| Southeast Statesboro | Homes, townhomes; a data center | 1,342 | 0 |
| Veterans Memorial Parkway west | Grocery-anchored retail, hotels | - | - |
| East Bulloch and Brooklet | Homes, a high school, aerospace jobs | 500 | 0 |
| Metter at I-16 | Auto suppliers; annexation at the exit | - | - |
| Downtown Metter | Little so far | - | - |
| Project | Size | Status | Last change | Source | Verified |
|---|---|---|---|---|---|

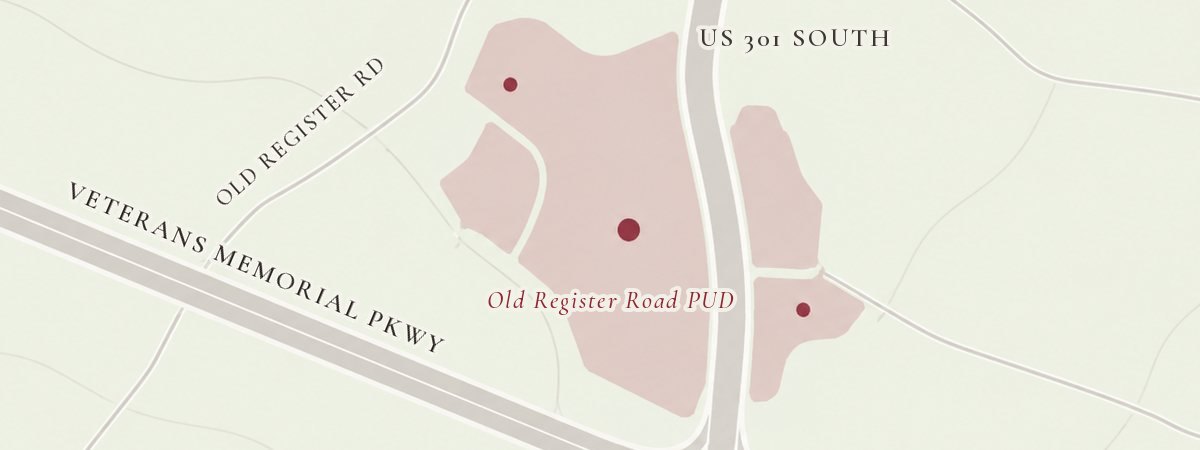

| Old Register Road PUD expansion Old Register Rd and US 301 S, Statesboro | 237.59 acres; about 1,173 units planned: ~500 apartments, 225 student cottages, 202 townhomes, 246 homes; hotel, offices, retail | Approved VSB Development. Annexation of 99.53 acres and PUD expansion approved Aug 19, 2025. Unit counts are plan figures. | Aug 2025 | Statesboro PC packet, Aug 5, 2025 Grice Connect, Aug 19, 2025 | Oct 2, 2026 |
| Herman Rushing Road townhomes 285 Herman Rushing Rd, Statesboro | About 198 townhomes on 38.54 acres | Approved Blue Water Bulloch. Annexation and R-2 rezoning approved 4-1 May 20, 2025. | May 2025 | Statesboro Herald, May 2025 Statesboro PC packet, May 6, 2025 | Oct 2, 2026 |
| Hunnicutt subdivision US 80 East at Hagan Ln, Bulloch County | 134 lots on 51 acres | Approved County rezoning AG-5 to R-8 approved 3-2 | Aug 2025 | Grice Connect, Aug 5, 2025 | Oct 2, 2026 |
| Zetterower Road residential Zetterower Rd, Statesboro | 17.83 acres to R-4 (high density); 192 apartments (independent senior living and multifamily) | Filed Zack Smith Properties. Planning commission recommended denial 7-0; staff also recommended denial. Council tabled it Sept 15 to Nov 17, 2026 for GDOT access, a traffic study and wetlands. | Sep 2026 | Statesboro PC packet, Sept 1, 2026 Statesboro council agenda, Sept 15, 2026 Statesboro council minutes, Sept 15, 2026 | Nov 2, 2026 |
| Canoochee airport-area data center proposal 2700 Airport Rd, Candler County near Metter airport | Applicant proposal: ~470 acres; five buildings each up to 250,000 SF; up to 1.25M SF; estimated 500 MW peak load and 0.2 MGD groundwater; 2033 target | Filed Canoochee River RV Resort LLC; DRI 4846 filed October 5, 2026, with proposed PUD rezoning and a county hearing advertised for Dec 8. No zoning approval, end user, financing, power service or physical start established. Applicant estimates are not commitments; Project Back in Black is a separate 100-MW fiscal model with unverified project linkage. | Oct 2026 | Candler County DRI 4846 WTOC, Sept 15, 2026 Colocation Scout, Nov 5, 2026 | Nov 13, 2026 |
| R&H planned development, Pretoria Rushing Road Pretoria Rushing Rd at Burkhalter Rd, Bulloch County | Up to 500 lots on 135 acres (about 95 buildable), per the county report | Approved PUD zoning dates to May 2014. On Jan 6, 2026 commissioners voted 3-2 not to revert it and kept it for two more years under a time limit. No final development plan filed; the developer is waiting for city water and sewer. | Jan 2026 | Statesboro Herald, Jan 2026 | Nov 2, 2026 |
| Project | Size | Status | Last change | Source | Verified |
|---|---|---|---|---|---|
| Coca-Cola bottling plant redevelopment 401 S Main St, Statesboro | 7.54 acres; 108 apartments (240 beds); restaurant and brewery in the 1920 warehouse | Approved OZ Business. PUD rezoning and variance approved unanimously Aug 18, 2026. | Aug 2026 | Statesboro council minutes, Aug 18, 2026 Statesboro Brief, Aug 24, 2026 | Oct 2, 2026 |
| Georgia Southern Foundation hotel and conference center Tillman Rd between Fair Rd and S Main St, Statesboro | 13.5 acres; hotel, conference center, alumni condominiums | Approved Board of Regents sale to the Georgia Southern Foundation for $2,673,000 (Feb 2026 agenda: at least 90 rooms and about 20,000 SF of conference space, ground lease to a development company, repurchase right if no financing or land-disturbance permit within 60 months). Foundation announced the purchase May 2026; rezoned to mixed use June 16, 2026. Developer and brand not announced; not a start. | Jun 2026 | USG Board of Regents agenda, Feb 10, 2026 Statesboro council minutes, June 16, 2026 Statesboro Brief, May 18, 2026 | Nov 7, 2026 |
| Statesboro Summit rehabilitation Statesboro | 98 units; up to $12 million in bonds | Approved Housing authority bond issuance approved Sept 15, 2026 (Resolution 2026-38). City issued an $11.6 million renovation permit Sept 28. Rehab, not new units. | Sep 2026 | Statesboro council minutes, Sept 15, 2026 Statesboro Brief, Sept 21, 2026 Statesboro permit report, Sept 2026 | Nov 2, 2026 |
| Project | Size | Status | Last change | Source | Verified |
|---|---|---|---|---|---|

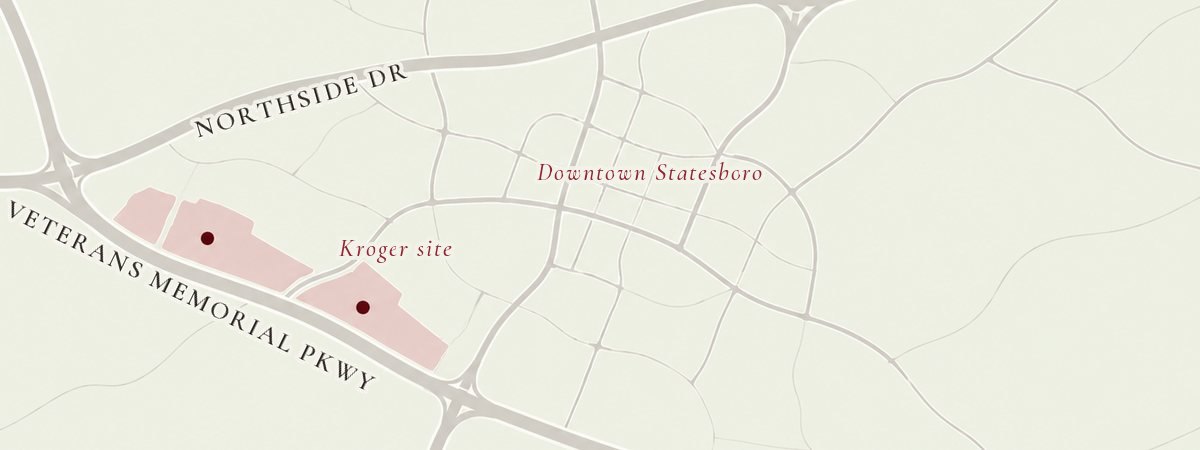

| Kroger Marketplace Veterans Memorial Pkwy at Cypress Lake Rd, Statesboro | 99,000 SF store; $45.7 million; anchors a 21-acre center | Started Construction began in August; Kroger held its official groundbreaking in October 2026. Opening fall 2027; reported jobs range from 250 to 400. Rezoned to mixed use Dec 2, 2025, with a 20% residential requirement on the side facing Whispering Pines. | Oct 2026 | Statesboro council minutes, Dec 2, 2025 Statesboro council minutes, May 19, 2026 WTOC, Aug 6, 2026 WTOC, Oct 22, 2026 | Nov 2, 2026 |
| Northside Drive store reuse Northside Dr E, Statesboro | Academy Sports (47,448 SF, former Publix); HomeGoods (former Kmart) | Complete Both stores are open. HomeGoods opened in the former Kmart; Academy Sports opened at 581 Northside Dr E on Oct 2, 2026 with about 60 jobs. | Oct 2026 | Statesboro council minutes, May 19, 2026 Statesboro Brief, Feb 16, 2026 WTOC, Sept 28, 2026 | Nov 2, 2026 |
| Fortner Road annexation Fortner Rd west of Crabby Ln, Metter | 46.76 acres; highway commercial zoning proposed for 990 Fortner Rd | Filed Hearing and first reading Sept 14, 2026. Applicants told the city they plan cold storage, a hotel, retail and fast food, plus a produce company headquarters (Metter Advertiser). Second reading and final vote not yet confirmed. | Sep 2026 | Metter public notice, Aug 12, 2026 Metter public notice, 990 Fortner Rd Metter Advertiser, Sept 22, 2026 | Nov 2, 2026 |
| Chesed Holdings retail rezoning, Highway 67 Highway 67, Bulloch County (parcel 110 000026 001) | About 30.8 acres, agricultural to commercial | Approved Commissioners approved it unanimously Nov 3, 2026 with 22 conditions (planning board 5-0), per a published meeting summary; official minutes not yet posted. No tenant or site plan published. | Nov 2026 | The Georgia Virtue, Nov 4, 2026 Bulloch County BOC agenda, Nov 3, 2026 | Nov 7, 2026 |
| Project | Size | Status | Last change | Source | Verified |
|---|---|---|---|---|---|

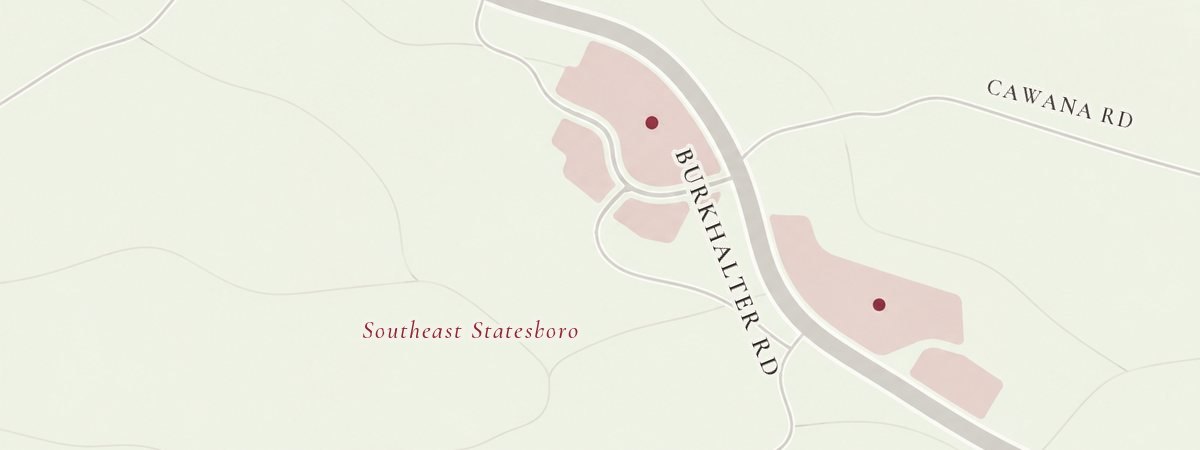

| Burkhalter Road data center 6539 Burkhalter Rd, Statesboro | 26.49 acres; ~230,000 SF; up to 99 MW requested; $1.2 billion over 10 years; 12 jobs | Approved 4AM Development. Rezoning approved 3-2 Aug 18, 2026. Residents sued Sept 17; City Attorney confirmed Nov 10 that processing of the required special-use permit is stayed pending litigation. The city asked to dismiss the suit. Prior special-use submission was described as incomplete. Rezoning alone does not authorize construction; developer says the site replaces 240 to 285 apartments. | Oct 2026 | Statesboro council minutes, Aug 18, 2026 Statesboro Brief, Aug 17, 2026 Statesboro Brief, Sept 28, 2026 Statesboro Brief, Oct 5, 2026 Statesboro Brief, Oct 26, 2026 | Nov 2, 2026 |
| Hyundai suppliers on US 301 South Bruce Yawn Commerce Park, Gateway park and nearby sites | Ajin/Joon Georgia $317M, 630 jobs; Ecoplastic $205M, 456 jobs; Hanon Systems $40M, 160 jobs | Started Ajin/Joon and Ecoplastic are operating; hired as of Aug 2026: Ajin/Joon 430, Ecoplastic 268. Hanon has confirmed 71 of its 160 promised hires and has until 2031 to reach the target (The Current, Sept 6, 2026). Ecoplastic land request for worker housing tabled June 2026. | Aug 2026 | The Current, Sept 6, 2026 Statesboro Herald, June 2026 Hanon Systems, company network Gov. Kemp: Hanon, May 23, 2023 | Nov 7, 2026 |
| Gateway Regional Industrial Park Phase II Off US 301 S, Statesboro | 69-acre Cannady site; $1.52 million state grant to make it pad-ready | Approved OneGeorgia grant awarded June 2025; listing location checked October 27, 2026. Pad-ready work completion unverified. | Jun 2025 | Expansion Solutions, June 2025 | Oct 2, 2026 |
| revalyu recycling plant Gateway Regional Industrial Park, Statesboro | 43 acres; $200 million+; 121 jobs in two phases | Started Groundbreaking Oct 2023; phase one was due Q3 2025. Current operating status not confirmed. | Oct 2023 | Statesboro Herald, Oct 6, 2023 EPD facility address | Oct 27, 2026 (location; stage remains unconfirmed) |
| American Aero 16274 US 80 E, Brooklet | 45,000 SF; from 100+ to about 300 employees | Started Groundbreaking March 24, 2026; completion expected end of 2026 | Mar 2026 | Grice Connect, March 2026 | Oct 2, 2026 |

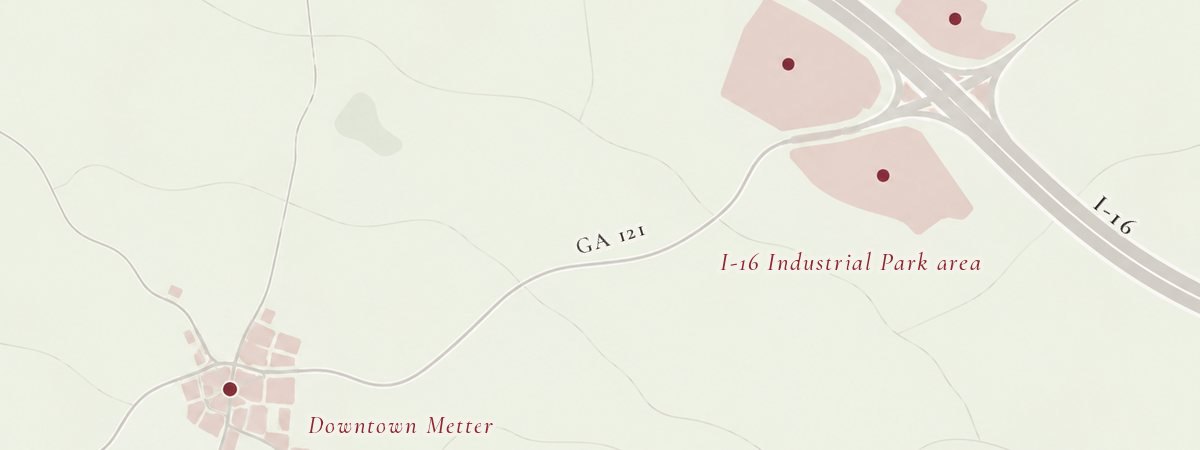

| Metter-Candler I-16 Industrial Park Lytell St, Metter | 130+ acres; DAS Corp. (300 jobs) and Doowon Climate Control ($30M+, 200 jobs) announced | Approved $103,500 state grant (Jan 2026) to renew certification and expand the park. DAS opened its plant with an Aug 13, 2024 ribbon-cutting; current headcount not published. Doowon operation not confirmed. A 24.97-acre addition is before the city. | Jan 2026 | The Georgia Virtue, Jan 31, 2026 Georgia DED: DAS, Sept 2023 Gov. Kemp: Doowon, Feb 6, 2024 Metter Advertiser: DAS opens, Aug 2024 Metter rezoning notice, Oct 14, 2026 | Nov 2, 2026 |
| Project | Size | Status | Last change | Source | Verified |
|---|---|---|---|---|---|
| Southeast Bulloch High School 9184 Brooklet-Denmark Rd, Brooklet | Up to $165 million; about 450,000 SF for about 2,000 students; $50.3 million in bonds sold | Approved Bonds sold Feb 2026. A construction database lists the project in design with a July 1, 2026 start date; we have not confirmed physical work. Opening about 2029-30. | Feb 2026 | WSAV, 2026 Statesboro Brief, Feb 16, 2026 ConstructConnect project record | Nov 2, 2026 |
| Southeast corridor roads Burkhalter, Harville and Cawana roads, Statesboro | Planned: two roundabout projects ($3.3 million; $2.75 million) and Burkhalter widening ($2.8 million); $193,500 corridor study; $1.2 million design contract | Approved City-county cost-sharing agreement Feb 2026; county study contract Sept 1. On Oct 6, 2026 both boards approved a $1,195,700 Kimley-Horn design contract (widening from Langston Chapel Rd to east of Herman Rushing Rd, a Cawana roundabout, GA 67 signals). Construction is about two years away. The city counts about 1,342 units planned in the corridor. | Oct 2026 | Statesboro Brief, Feb 23, 2026 Statesboro Herald, June 2025 (units and road costs) Statesboro Brief, Aug 31, 2026 Statesboro council minutes, Oct 6, 2026 Statesboro Brief, Oct 12, 2026 | Nov 2, 2026 |
| East Georgia Regional Medical Center ER expansion 1499 Fair Rd, Statesboro | About $16 million; 8,750 SF addition, 12 more rooms | Approved City issued the building permit Sept 9, 2026 ($14.15 million for the addition and renovation, plus an ambulance canopy). Hospital targets late 2027. Start of physical work not yet confirmed. | Sep 2026 | Statesboro permit report, Sept 2026 Statesboro Brief, Oct 5, 2026 | Nov 2, 2026 |
Filed means on an agenda or in an application. Approved means a board or council voted yes; we name the step. Started means construction confirmed by the developer or the city. Every row carries a source and the date we last checked it.
Sources: Statesboro City Council and Planning Commission; Bulloch County Board of Commissioners and Planning and Zoning Commission; Brooklet City Council; Metter City Council; the Development Authority of Bulloch County and the Candler County Industrial Authority; Bulloch County Schools and Georgia Southern University; state economic development announcements. Agendas and minutes are the primary record; press coverage fills in announcements and groundbreakings. We report what the record says and label what is not yet confirmed. This report is updated through the month; each month gets a new report.
See something we missed or got wrong? Tell us. How Redchip researches and verifies: Method.
Disclosure: the author is a partner in Vanguard Industrial Partners, which develops projects in the Southeast and may pursue projects in this market. General information only; see the disclaimer.
